The tunnel under the Bay of Havana, called Túnel de La Habana (Havana’s Tunnel) or the Túnel de la Bahía (Tunnel of the Bayl), is considered as one of the seven wonders of Cuban civil engineering. It is one of the three tunnels under the water in Havana.

HISTORY

The expansion of Havana towards the west and the increase in the population density in this area, led to the construction of several bridges on the Almendares river, such as the Puentes Grandes bridge in Cerro, the Asbert bridge, connecting the 23th street to the 28th street (Kohly) and the Pote bridge, connecting Malecón (Calzada) to Miramar.

On the other hand, in the middle of the 19 the century, the communication of Havana with the east was only through narrow roads around Guanabacoa that made the drivers waste much time. Several ideas were suggested to bypass this route of about 25 kilometers that took more than half an hour, and to facilitate the traffic towards the east and Pinar del Rio. In the meantime, the urban planners of the time, encouraged by the politicians and the investors, were after building an entirely new city to the east of the existing urban center. Extending the city to the Santa Maria beach would enable the settlement of 200.000 people at minimum in the next 30 years. Finally, it was concluded to construct a tunnel under the Bay of Havana that would connect the city center directly to outside of the city.

The concession to construct the tunnel and the Monumental Way after the tunnel that would connect the tunnel to the current Via Blanca, was granted to Compañía de Fomento del Túnel de La Habana, SA, that signed the contract with the French company Societé de Grand Travaux de Marseille in June 1955. The French company had built the tunnel that connects Linea to Miramar (Avenue 5b) that still works. The excavation work was conducted by the Cuban company Perforadora Panamericana, owned and operated by Cuban engineers Gerardo and Fernando Pérez Puelles. The Frederick Snare Corporation was charged with the on-site inspection of the construction process.  The project was designed under the direction of the Cuban engineer José Menéndez Menéndez. After a construction process under difficult conditions, the tunnel was inaugurated in May 1958.

THE TUNNEL

The 733-meter long tunnel runs at a depth of approximately 12 or 14 meters below the seabed. Together with the connecting roads, the tunnel net is about 1.600 meter long. More than 250.000 m3 of rocks and 100.000 m3 of sand had to be dug up to complete the tunnel project.

The tunnel under the bay consists of five sections of prefabricated concrete pipes that are capable of withstanding the weight of thousands of tons of water. They are 100.7 meters long, 22 meters wide and about 7 meters high. They were built in a dry dock and floated to the site where they were submerged. The weight of each tube is 16.000 tons. The underwater tube system is combined with the land sections of the tunnel at its each end. The central tube is horizontal and has a length of 90 meters. The slope of the tunnel does not exceed 5.75% at any section.

At each side of the central partition wall that separates the traffic in opposite direction, there are sidewalks of about 90 cm wide that serve for the police surveillance.  The tunnel is closed to the pedestrian access.

The tunnel has two traffic lanes of about 3.4 meters in each direction. A maximum speed of 60 km/h is allowed within the tunnel, so that it takes only 45 seconds from one end of the tunnel to the other, saving tens of kilometers around the bay.

The tunnels ventilation is provided by twelve fans installed in two ventilation towers situated on both sides of the bay. They had the capacity to renew the air inside the tunnel within approximately one minute. The carbon monoxide content inside the tunnel is automatically checked.

Underground gutters were used to accumulate the rainwater in two big cisterns placed near the portals, where the water is sucked by six pumps and discharged to the sea.

The tunnel contains safety gates and a phone line, consisting of seven telephones installed at different places in the tunnel. The tunnel is equipped also with fire protection systems.

RULES

It is not allowed to pass through the tunnel by foot, by horse-drawn vehicle, by bicycle or by motorcycle without sidecar, but there are bicycle busses, so that you can take your bike into the bus and get out of the bus after the tunnel.

It is forbidden to change the traffic lane in the tunnel. You will need to turn on the headlights before you will enter the tunnel.  When you exit the tunnel on the eastern end, you should drive with a speed of maximum 30 km/h until you will pass the police control at the toll. The policemen just at the exit and at the toll control whether the drivers obey these rules.

The entrance of the tunnel in Old Havana is opposite the Castillo San Salvador de la Punta in front of the Monument of Máximo Gómez on Malecón. You can exit the tunnel through different exits on Malecón either in the direction of the harbor or in the direction of Vedado.

1 / 5

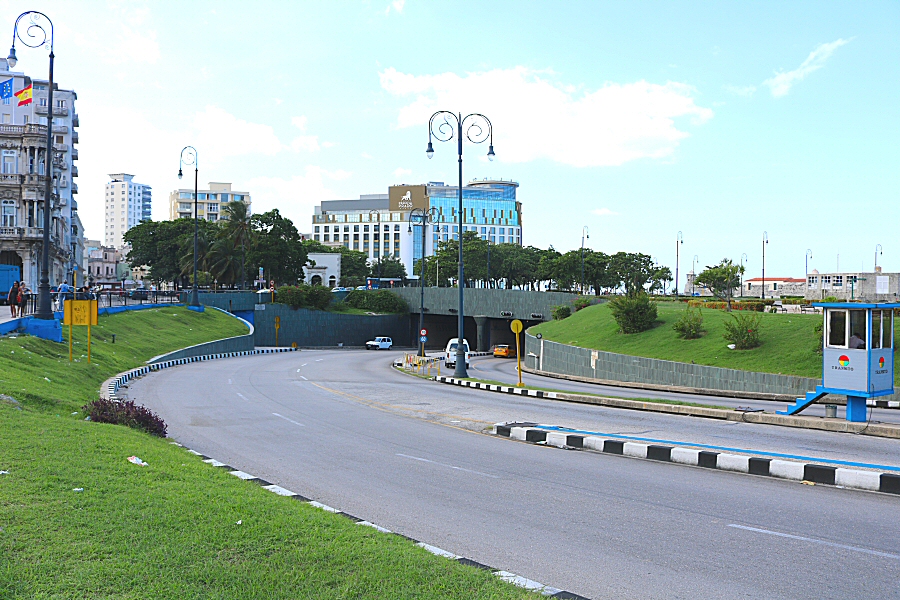

entrance of the tunnel on the Malecón
2 / 5

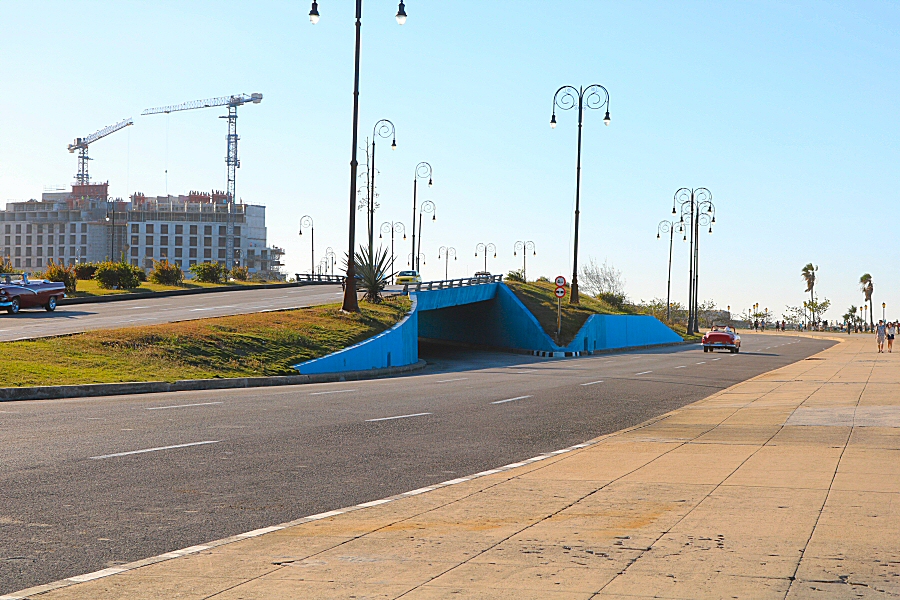

the other entrance of the tunnel on the Malecón
3 / 5

the exits of the tunnel on Malecón in the direction of Vedado and the harbor
4 / 5

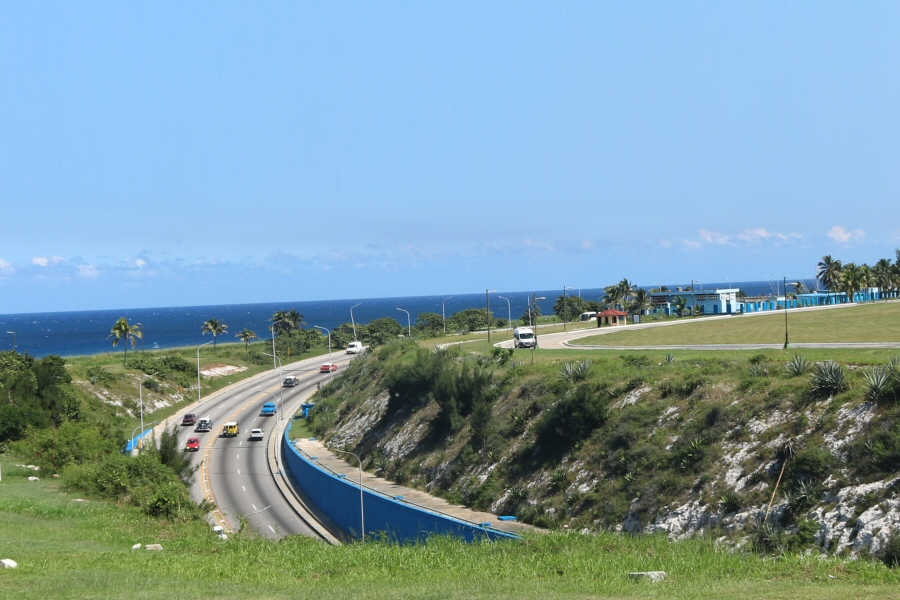

exit of the tunnel at its eastern end

×
